TL;DR: Most approval workflow templates give you a sign-off box and assume the rest figures itself out. This one shows IT company owners how to build a decision-routing system: authority levels, conditional logic, escalation paths, and audit requirements mapped before the first notification fires. Six steps, each tied to a specific bottleneck it prevents.
What an approval workflow template actually does
A template for approvals isn't a checklist. It's a routing system: a defined path that moves a request from submission to decision, with the right person making the right call at each stage.
The distinction matters because most teams that struggle with the project approval process steps aren't missing a sign-off box. They're missing two things: clear authority levels (who can approve what, up to what spend or scope threshold) and conditional logic (what happens when the first approver rejects, delegates, or goes silent).
An approval workflow template in project management captures both. It defines the trigger that starts the process, the sequence of reviewers, the conditions that route requests to different paths, and the rules that escalate when someone doesn't respond.
A checklist tells you what to collect. A template tells the system what to do next, automatically, without someone manually chasing a reply.
That's the real work. Authority levels and conditional logic aren't configuration details — they're what separates a template that prevents bottlenecks from one that just documents them after the fact.

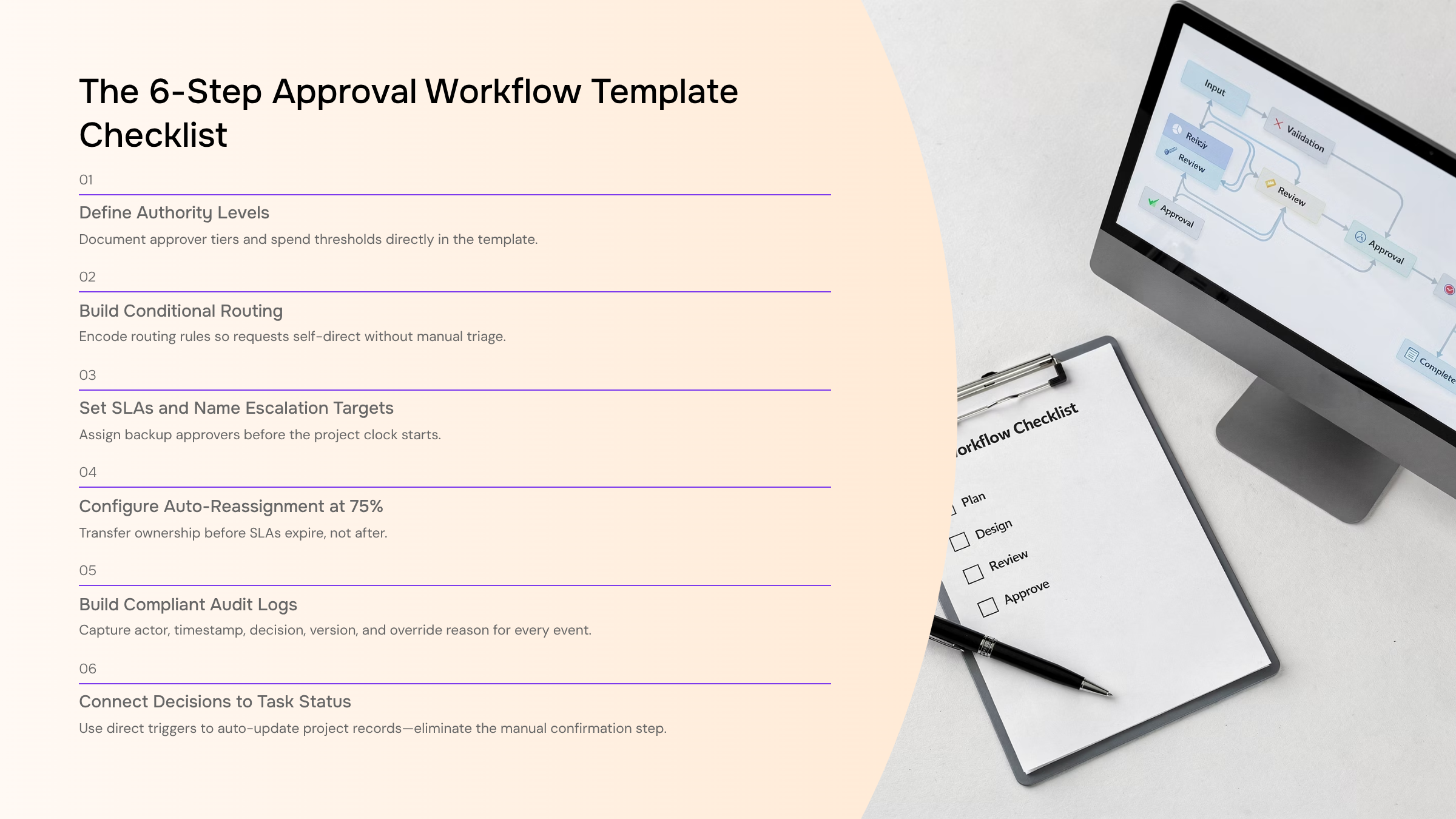

Core components every approval template must include
Six fields separate an approval workflow template that prevents bottlenecks from one that just documents them after the fact.
Approver role (not a name, a role): Naming a person breaks the template the moment they're out of office. Assign the role — "IT lead," "finance director" — so routing survives turnover and absence.
SLA per approval tier: Without a deadline attached to each step, requests sit in inboxes indefinitely. A 24-hour SLA for routine approvals and 48 hours for budget exceptions gives approvers a clear expectation and gives you a trigger for escalation.
Escalation rule: Define what happens when the SLA lapses: who gets the request next, and after how long. This single field is the most common omission in generic templates, and its absence is what turns a two-day approval into a two-week one.
Conditional logic: A $500 expense and a $50,000 contract should not follow the same path. Conditional routing — "if budget exceeds X, route to CFO" — is where approval bottleneck prevention actually happens in practice.
Audit log requirement: Frameworks like SOC 2 and ISO 27001 require documented evidence of who approved what and when. An audit trail in project management isn't optional for compliance-bound teams — it's the record that protects you during an audit.
Notification rule: Every status change needs a defined recipient. Requestors who don't know their submission stalled will re-submit, duplicate work, or escalate through the wrong channel.
The Approval Workflow Checklist Matrix
The matrix below maps every common approval trigger to the six template fields from the previous section. Use it as your approval workflow template project management reference when you're configuring a new workflow or auditing an existing one.
Trigger Type | Approver Role | SLA | Escalation Rule | Conditional Logic | Audit Log Required | Notification Rule |
|---|---|---|---|---|---|---|
Budget threshold | Finance lead + Project sponsor | 24 hours | CFO at 48 hours | Route to CFO if >$50K | Yes (SOC 2, ISO 27001) | Slack/email on submission and decision |
Scope change | Project manager + Client stakeholder | 48 hours | Escalate to program director at 72 hours | Parallel if both approvers needed simultaneously | Yes | Email on submission; SMS if SLA breached |
Timeline extension | Project manager | 24 hours | Escalate to delivery lead | Skip if extension <3 days | Yes | Email only |
Resource allocation | Department head | 48 hours | Escalate to COO if cross-department | Route to COO if headcount >2 FTEs | Yes | Email on submission |
Quality gate | QA lead | 12 hours | Escalate to CTO | Block deployment if gate fails | Yes (GDPR, ISO 27001) | Immediate Slack alert on failure |
Compliance review | Legal + Compliance officer | 72 hours | Escalate to General Counsel | Mandatory; no conditional skip | Yes (all frameworks) | Email with deadline reminder at 48 hours |
A few things to read across each row before you build:
SLA and escalation rule travel together: An approval SLA escalation without a named escalation target is just a timer that expires. Name the person, not just the role category.
Conditional logic isn't optional for budget and resource rows: Conditional approval routing prevents a $5K purchase request from sitting in the same queue as a $500K contract reallocation.
Audit log requirement is non-negotiable for compliance and quality gate rows: Frameworks like SOC 2 and ISO 27001 require documented approval trails, not just a record that a decision happened.
For teams building these workflows inside a project tool, workflow management practices that keep approval queues from becoming the slowest step in your project covers the queue hygiene side. If routing and e-signature are part of your compliance requirement, how document approval systems handle routing and e-signature integration is the right next read.
Sequential, parallel, and conditional approval: when to use each
The structure you choose for an approval step determines whether work moves or stalls.
Sequential approval routes the request to one approver at a time, in a fixed order. Use it when each reviewer's decision depends on the previous one — a finance lead who needs a department head's sign-off before committing budget, for example. It's the right call for budget threshold and compliance triggers, where accountability needs a clear chain. The tradeoff: every step adds calendar time, so sequential approval without an SLA becomes a bottleneck by design.
Parallel approval sends the request to multiple approvers simultaneously. Use it when reviewers are independent — a resource allocation request that needs sign-off from both the HR lead and the project sponsor, neither of whom needs to wait on the other. Parallel routing cuts approval cycle time significantly on multi-stakeholder decisions. The risk is conflicting responses, so your approval workflow template needs a defined resolution rule: majority, unanimous, or first-to-respond.
Conditional approval routes the request based on attributes of the request itself. A scope change under 10% goes to the project manager; over 10% escalates to the steering committee. This is conditional approval routing in practice, and it's the most powerful of the three for project approval process steps because it eliminates manual triage entirely.
Matching the right structure to your trigger type is the first decision in Taro — before SLAs, before escalation paths, before notifications.
How to set SLAs and escalation rules that prevent bottlenecks
Four decisions determine whether your approval workflow template project management setup prevents bottlenecks or creates them.
SLA window by trigger type: Not every approval carries the same urgency. A budget change over $10K warrants a 4-hour SLA; a routine scope clarification can sit at 24 hours. Define the window at the trigger level, not as a blanket rule across your template.
Escalation path: When an approver misses the SLA window, the next step should already be named. Map it before the project starts: primary approver → their direct manager → project sponsor. Three levels is usually enough. If you need more, the approval authority structure is the real problem.
Auto-reassignment logic: Conditional approval routing breaks down when an approver is out of office and no reassignment rule exists. Set a rule: if no action within 75% of the SLA window, auto-reassign to the backup approver. This one rule eliminates most approval bottlenecks without any manual intervention.
Stakeholder notification timing: Notify the requester when the SLA clock starts, not when it expires. Send the approver a reminder at 50% of the window. That cadence catches delays early, when there's still time to act.
These four decisions also determine what your approval SLA escalation logs need to capture for audit purposes, which the next section covers in detail. For teams building this into a connected project process, workflow examples that map approval steps inside a broader project show how the pieces fit together.
Audit and compliance requirements to build into every template
An audit log isn't a nice-to-have in an approval workflow template for project management. For IT teams operating under SOC 2, ISO 27001, or GDPR, it's a control requirement. If you can't produce a timestamped record of who approved what and when, you don't have a defensible audit trail — you have a gap.
Every approval log entry should capture five things:
Actor: the specific user who took the action, not just a role name
Timestamp: date, time, and timezone at the moment of decision
Decision: approved, rejected, or escalated, with the version of the document or task in scope
Version: the exact iteration reviewed, so you can prove what was approved
Override reason: if someone bypassed the normal path, the justification must be recorded
This matters for audit trail project management accountability. When a regulator or internal auditor asks why a change shipped without a security review, the log answers that question in seconds rather than hours of Slack archaeology.
For teams building reusable workflow templates that hold up as approval thresholds change, baking these five fields into the base template means every new workflow inherits the same compliance baseline automatically.
How approval workflows connect to project task and status updates
An approval decision that lives outside your task system creates a gap. Someone approves a deliverable in a separate tool or email thread, then manually updates the task status, or forgets to entirely. That gap is where approval bottlenecks form, and it's one of the most common failure points in the project approval process steps that IT teams run.
The fix is a direct trigger: when an approver marks a request approved or rejected, the downstream task state changes automatically. No manual handoff. A rejected design review moves the task back to "In Progress" and notifies the assignee. An approved budget request advances the project phase and unlocks the next task in the sequence. This is what separates a connected approval workflow template project management setup from a static checklist.
Taro closes this loop at the execution layer. When an approval fires inside a project, the linked task updates its status, assignee, and due date without anyone touching it manually. Paired with Revo for cross-system automation, a single approval decision can also update a CRM record or trigger a billing milestone in Inzo.
For teams building this from scratch, reusable workflow templates that scale as approval thresholds change give you a starting structure that doesn't require rebuilding every quarter.
Closing
An approval workflow template that prevents bottlenecks isn't about collecting more signatures. It's about routing decisions to the right person at the right time, with clear authority levels, SLAs, and escalation paths baked in before the first request lands in an inbox. The six-step framework above gives you the structure; the Approval Workflow Checklist Matrix gives you the reference to audit or build your own.
The real payoff happens when your approval triggers, SLAs, and escalation rules live inside a project execution layer where task ownership, status updates, and approval decisions stay connected—not scattered across email threads and spreadsheets. Taro is built for exactly this: approval routing with SLA timers, conditional logic, and automatic task status updates so your team knows instantly when a decision is made and what happens next. Start by mapping your highest-friction approval trigger (usually budget or scope change) using the matrix above, then ask yourself: where does that approval decision live today, and who has to chase it manually?
FAQ
What are the core components every approval workflow template must include to avoid delays and rework?
Approver role (not a name), SLA per tier, escalation rule, conditional logic, audit log requirement, and notification rule. Without all six, requests stall in inboxes or skip critical reviewers.
How should approval workflows handle conditional routing based on request type, amount, or stakeholder availability?
Route based on request attributes—a $500 expense and a $50K contract follow different paths. Define thresholds in your template so conditional logic routes automatically without manual triage.
What is the difference between sequential, parallel, and conditional approval workflows, and when should you use each?
Sequential chains reviewers in order (use for budget accountability); parallel sends to multiple approvers at once (use for independent stakeholders); conditional routes based on request attributes (use to eliminate manual triage).
How do you set SLAs and escalation rules within approval workflows to prevent bottlenecks?
Pair SLA with a named escalation target—24 hours to the first approver, then escalate to the CFO at 48 hours. An SLA without escalation is just a timer that expires.
What audit and compliance requirements should be built into an approval workflow template?
SOC 2, ISO 27001, and GDPR require documented approval trails. Audit logs must capture who approved what and when—non-negotiable for compliance and quality gate triggers.
How should approval workflows integrate with task and project status updates?
Approval decisions should automatically update task ownership and project status so your team knows instantly when a decision is made and what happens next, not buried in email.
What are the most common project management challenges with approval processes and how do you overcome them?
Requests stall without escalation rules, wrong people approve due to missing conditional logic, and teams duplicate work because they don't know a decision was made. The Approval Workflow Checklist Matrix prevents all three by mapping triggers to routing rules upfront.
Get tactical playbooks every Tuesday
One email. 5-min read. Tactical reads for B2B operators who actually run the business.
Join 48,000+ B2B operators · Unsubscribe anytime
David Okonkwo is a Business Process Consultant & Workflow Automation Expert who has redesigned operations for companies across Africa, the UAE, and Europe. He writes about removing bottlenecks, building systems that survive team changes, and why most process problems are actually tool problems wearing a different disguise.
